A healthier home comes down to how it's built.

We are a team of passionate building science experts whose mission is to improve the way we build homes.

Homeowners increasingly understand that their homes affect their health. They want better indoor air, cleaner water, healthier materials, moisture resilience, and lasting performance.

But building a healthier home requires hundreds of connected decisions. Information is fragmented, product claims are difficult to compare, and many project teams lack specialized expertise across every category.

The Well Build makes complex building decisions easier to understand and act on.

CertifiedPassive House Tradesperson
Experience15+ years in healthy building
Works withHomeowners, builders, architects
Read Rachel's story →

Our consulting services

Three ways to work with us.

Every project is different. Choose the level of support that matches your build — from a single call to full-service oversight from early planning through move-in.

We take on a limited number of projects at a time, on new builds, major renovations and additions. We work alongside your builder, not against them, and bring in trusted specialists when a project calls for it.

Master planMost common

The Well Build Master Plan

Typical duration4–6 weeks

Our complete pre-construction engagement: we review your plans, develop your full healthy-home material specifications, and coordinate with your builder and architect on a game plan for the build.

Best forHomeowners who have plans and a team, and are ready to build healthy.

  • Full review of your plans, specs and project documentation
  • Healthy-home material specifications developed for your build
  • A written game plan your builder and architect work from
Start with the intake form
Build phase

Build Phase Advisory

Typical duration6–12 months

Everything in the Master Plan, plus ongoing advisory support through the construction phases where building-science decisions are hardest to fix later.

Best forHomeowners who want eyes on the project through the critical phases.

  • Everything in the Master Plan
  • Ongoing advisory through the phases that are hardest to fix later
  • A virtual pre-drywall review before the walls close
Start with the intake form
Full service

Full-Service Consulting

Typical duration12+ months

We work alongside your architect, builder, engineers and interior designer from early planning through post move-in, coordinating decisions across every system.

Best forComplex builds that need continuous oversight.

  • Support from team selection through move-in
  • Coordination across architect, builder, trades and interior design
  • Ongoing review of systems, materials and construction progress
Start with the intake form

Project engagements start in the five figures and scale with the size and complexity of your home. Tell us about your project and we will come back with pricing and next steps. Have one specific question instead? Book a one-time strategy call for $999.

Timing

When to bring us in.

Timing changes what's possible. Early on, a change is a line on a drawing. Once the walls are closed, it's demolition — which is why our full engagements start before construction, not during it.

01Ideal

Land & design

Site, orientation, assemblies and mechanical strategy are all still open. The cheapest point to change anything.

02Ideal

Permit set

Plans reviewed, materials specified and your builder aligned before pricing and details get locked.

03Still works

Foundation

Below-grade waterproofing, vapor barriers and drainage. Tight, but there's still real ground to cover.

04Still works

Framing

Sheathing, flashing, window installation and moisture details are all still ahead of you. The house itself is set, but plenty is still worth getting right.

05Strategy call

Rough-in & pre-drywall

The last look before everything is covered. Best used on one or two decisions you need to get right.

06Strategy call

Finishes & move-in

Finishes, ventilation setup, filters and how to run the house once you're living in it.

Master Plan, Build Phase & Full-Service
One-time strategy call

Stages 01–02 are where our engagements belong, and where most clients find us. Stages 03–04 still work. Past that, a single strategy call is usually the honest answer — tell us where you are and we'll say so.

What we look at

Everything that matters is inside the wall.

Once the drywall goes up, you'll never see these layers again. Here's what we check in every exterior wall, outside to in, and the defect each one prevents. Tap a layer.

The specifications shown here are examples. Every recommendation we make is custom to your project, your budget and your climate zone — a wall that performs in Vermont is not the wall we would specify in Florida.

Cross-section of a healthy exterior wall, eight layers from outside to inside OUTSIDE INSIDE 40–60% RH fresh air via ERV 12345678

What goes wrong
What we specify

Example only — not a specification. What we'd actually recommend depends on your climate zone, assembly and budget.

Also on every review Ventilation (ERV / HRV)Humidity controlHVAC sizingRoof & attic assembliesBasement & slab moistureWet-area waterproofingMaterial off-gassingLow-EMF planningWater quality And more

What you actually get · 01

The plan review.

We read your drawings the way a builder does, mark what will cause problems later, and explain the reasoning — the condition, why it matters, and what to do instead.

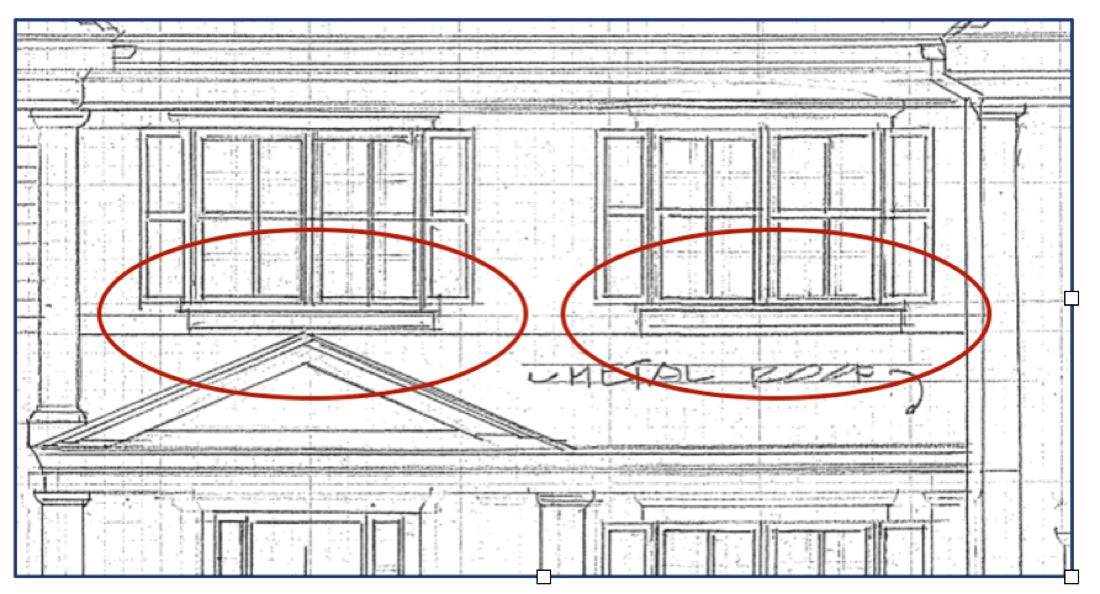

Elevation drawing with two windows circled where they sit too close to a roofline
Elevation, marked up during plan review
Example flagged area

Windows set too close to the roofline

Why it matters

When windows are placed too close to a roofline, they sit in a high water and splash zone. Roof runoff can overshoot flashing and repeatedly wet the window assembly, increasing the risk of leaks, rot and premature window failure.

What to look for
  • Maintain ~12" minimum vertical clearance between the bottom of the window and the roof surface — more is better when possible.
  • Consider running ice and water shield from the roof deck up the side wall to the bottom of the window.

Drawing from a real plan review. Client and builder details removed.

What you actually get · 02

The contractor specifications.

Findings become line-by-line specifications your builder and trades work from — their spec beside ours, with the reasoning behind every call.

Contractor specifications · excerpt Contractor Specifications | Healthy Home Guidance
Vapor barrier (under slab)
Builder's spec

5 mil polyethylene

The Well Build notes

Specify 10 mil minimum — 5 mil tears during the pour and under foot traffic. Seal around every penetration, and run the barrier up the wall and cut it back later, so vapor and soil gases can't migrate up the side.

Crushed stone under slab
Builder's spec

Included

The Well Build notes

Specify #57 (3/4") gravel explicitly on the plans, 4" minimum. "Crushed stone" is too vague to hold a subcontractor to.

Framing lumber
Builder's spec

#2 SPF

The Well Build notes

Kiln-dried only, stored off the ground and covered. Stagger deliveries so lumber isn't sitting in the weather before close-in.

Flooring over new slab
Builder's spec

LVP, install per schedule

The Well Build notes

Test the slab for moisture before any impermeable flooring goes down. New concrete releases moisture for months, and LVP or rubber mats trap it — which is how you get mold under a brand-new floor.

Excerpt from a real plan review. Client and builder names removed.1 of 24 pages

Included in every project engagement

  • 01A written review of your plans, with what we'd change and why
  • 02Healthy-home material specifications for your project
  • 03A project guidance document your team builds from
  • 04Follow-up calls, plus 30 days of email support
  • 05Our healthy-home guides, for you and your trades

Single strategy calls are scoped individually.

Want to work with us on your project? Fill out our intake form →

A new build, alongside the builder

What stood out most to me was not only their expertise, but the way they worked with both me and my builder. They treated my builder with genuine respect for his experience and collaborated so well as a team.
Lauren T.Tennessee · new build
They take the guesswork out of choosing healthy materials, provide clear and accurate pricing options, and stay closely connected with local reps and installers.
Addison K. · Utah · building for a client
I was terrified the same mistakes would be made in the rebuild. She walked me step by step through how to rebuild correctly.
Tiffany H. · California · rebuild after water intrusion
My only regret is not bringing them on earlier, during the planning stage.
Marcy A. · Virginia · custom build

Projects

Healthy homes look like this long before they look finished.

New construction and renovations we've guided, from framing and flashing to the finished kitchen.

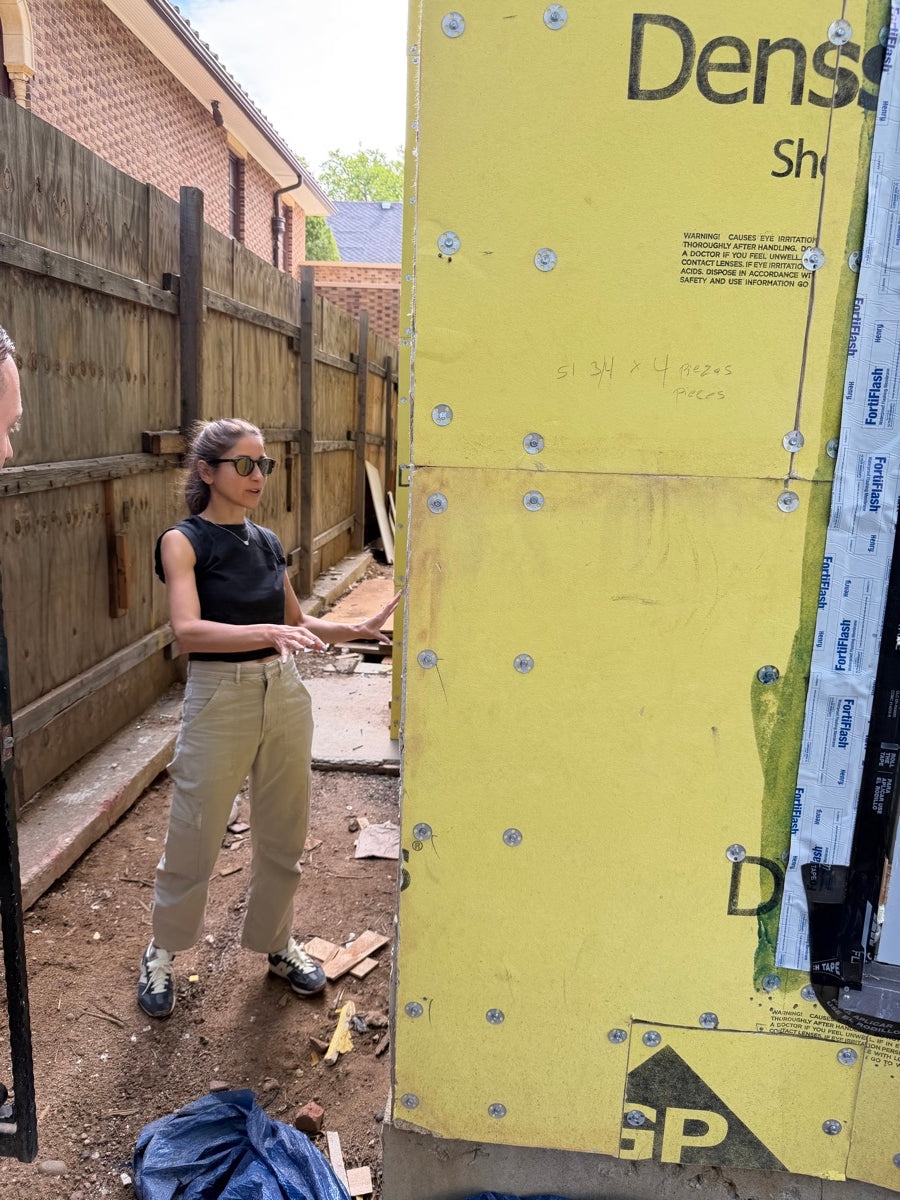

Exterior sheathing and window flashing, mid-build
Brooklyn, NYNew construction
Weather-resistive barrier around a window opening
Orange County, CANew construction
Shower waterproofing membrane before tile
Tulsa, OKNew construction
Masonry block walls with window openings
Boca Raton, FLNew construction
New house on a cleared site
Wainscott, NYNew construction

See more projects →

Learn

Learn the building science yourself.

Guides, webinars and toolkits drawn from the same playbook we use with consulting clients. No project required — start where you are.

Spec book · online The Well Build Standard The Healthy Home Spec Book.

Spec book · onlineComing soon

The Well Build Standard

Want to know when it's ready?

We'll email you once, when it launches. Unsubscribe anytime.

The Top 20 Things I See Wrong in New Builds
Free guide

The Top 20 Things I See Wrong in New Builds

The failures we find over and over on new construction — and what they cost to fix later. Free, with photos from real job sites.

  • 20 failures we find on new builds, with photos from real job sites
  • Why each one gets expensive once the walls close up
  • A 20-line walkthrough checklist to hand your builder

Get the guide, plus occasional notes from the job site. Unsubscribe anytime.

Products We Love

What we use in our own homes.

The tests and products we actually specify on projects and use ourselves. Some links are affiliate or discount links.

Questions

The things people ask us first.

If your question isn't here, send it along with your project details and we'll answer it directly.

Where do you work?

Everywhere. We're based in New York, but almost all of our work is remote, and we've guided projects across the country — plus a few well outside it. We review plans, documentation and progress photos, and join calls with your local team, so where you're building isn't a limitation.

What does it cost to hire you for my project?

Project engagements start in the five figures, and scale with the size and complexity of your home and how long you want us involved. We don’t publish fixed prices because no two projects need the same scope.

The intake form asks what you’ve set aside for this kind of guidance, so we can come back quickly with real pricing. If a full engagement is more than your project needs right now, a one-time strategy call is $999.

Do you inspect or certify the work?

We don't certify work, and we don't perform code or structural inspections on site. All design and construction decisions remain the responsibility of you and your licensed professionals.

What we do on Build Phase Advisory and Full-Service engagements is review progress photos and video from the site and give your builder and trades real-time feedback — so problems get caught while they're still easy to fix.

Do we still need our architect and builder?

Absolutely. We don't replace anyone on your team. We work alongside your architect, builder and trades — the projects that go best are the ones where everyone is aligned early.

What if our builder doesn't want to work with a consultant?

It's worth asking them directly. We work with all types of contractors, and most appreciate having the building-science details specified clearly up front rather than discovering them mid-build.

Do you help with water filtration?

Yes. Water quality is part of every project review, and we can help you test your water and work out what your home actually needs — whole-house, point-of-use, softening, or nothing at all.

What happens after I submit the form?

We read every submission. If we think there's a potential fit, we'll reach out with next steps. We take on a limited number of projects at a time, so we'd rather tell you honestly than stretch ourselves thin.
